This page has older content

Please see Related Projects on this page for current project information. We are keeping this page as a record of SFMTA outreach.

Central Subway Construction Update 12/15/17

Share this:

Thank you for your interest in the Central Subway Project, which is a significant project in the history of San Francisco's public transportation network. This project is the first underground line to link the north and south corridors of the city, and will provide a direct connection to major retail, sporting and cultural venues while efficiently transporting people to jobs, educational opportunities and other amenities throughout San Francisco.

This is an exciting time as the San Francisco Municipal Transportation Agency's | Central Subway team works to construct a vital transportation link that, when open in 2019, will improve connectivity for the city.

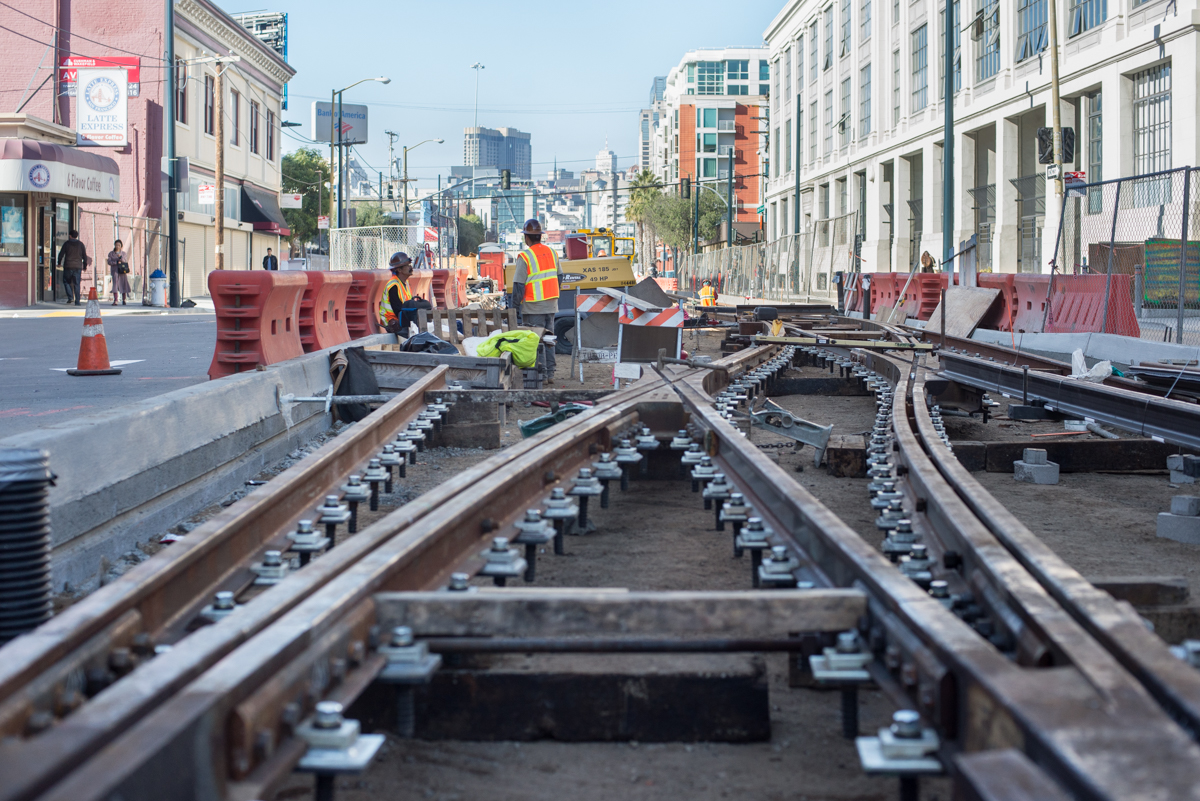

New tracks are being placed along the surface portion of the alignment along 4th Street in SoMa. Central Subway | Project Advancement

December 15 through December 24, 2017

This notice provides a construction update and a look ahead for what to expect in the areas where we are building four new stations along the alignment. You’ll find information about work activities, traffic and transportation impacts taking place over the next two weeks at SoMa, Yerba Buena/Moscone, Union Square and Chinatown.

Construction schedules, bus routes, and stop locations are subject to change due to unforeseen conditions. Signs will be posted at affected stops to advise of service changes.

Our thanks go out to the businesses, residents, shoppers, commuters, and all those who are touched by the Project, for their continued engagement as we work to extend the city's public transportation system.

The Central Subway Team

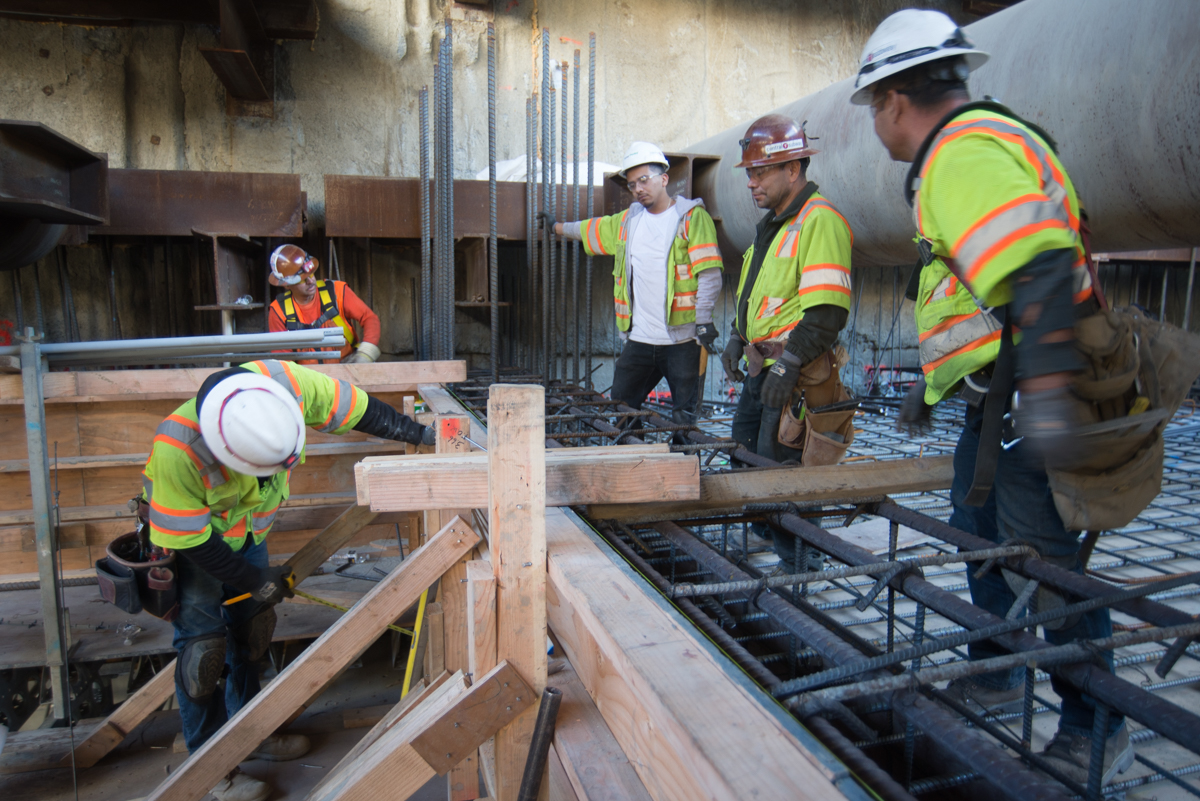

Foundation work for the 4th and Brannan surface station is being conducted in the center median. Surface Station, Trackwork and Systems Work along 4th Street between Bryant Street and King Street includes construction of a surface station between Bryant Street and Brannan Street. The construction team is upgrading utilities and trackwork on 4th Street between the tunnel portal at Bryant Street and the connection with the existing light rail system at King Street.

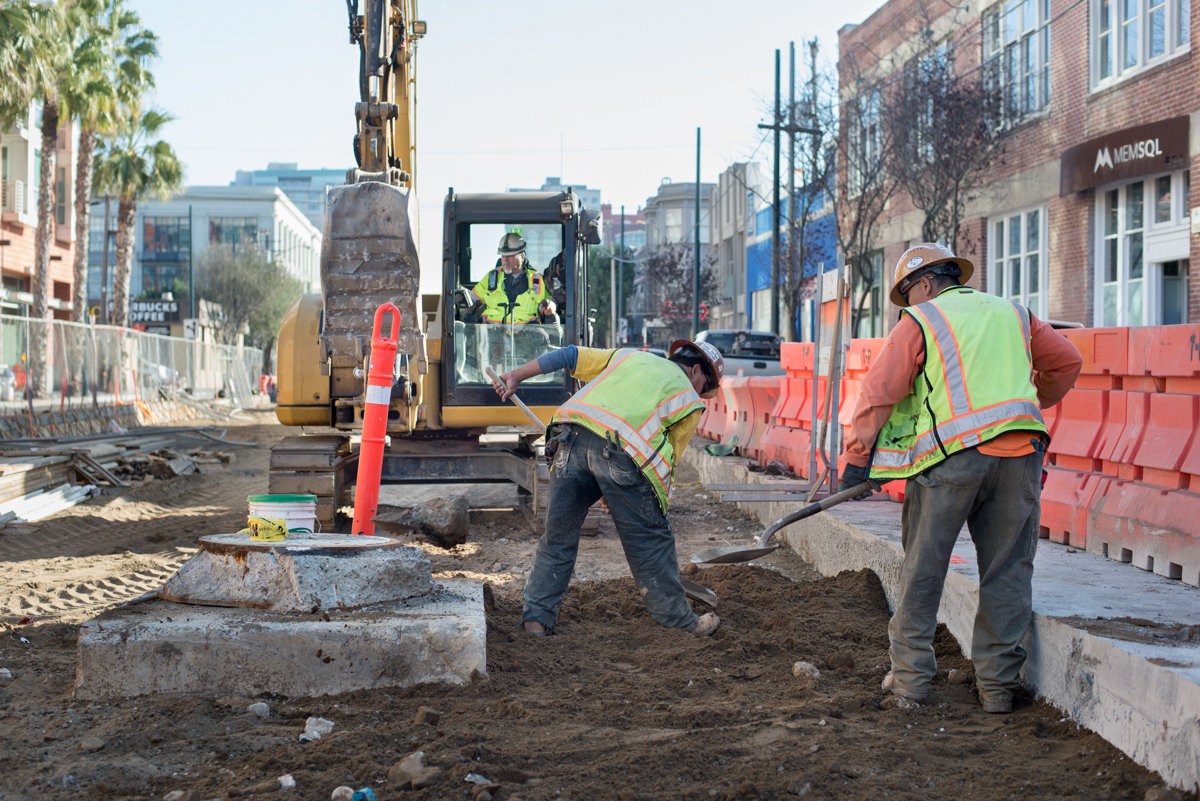

Water line replacement work is underway on 4th Street at Brannan, and night work is ongoing between 8:00 PM and 5:00 AM.  Track installation work is ongoing between Brannan and King.  Some lane closures may also occur at night.  Regular day shift hours are from 7am to 4pm.  Workers prepare the center median to install track curbs and other track foundation work to be constructed. Concrete forms to construct track curbs are being installed along the edges of the center median of 4th Street south of Bryant. Overview

  • Utility upgrade and relocation
  • Night work on 4th between King and Bryant
  • Street and sidewalk restoration

Details

What: Night utility work on 4th between King and Bryant
Time: 8 p.m. - 5:00 a.m.
When: Monday to Saturday
Where: 4th Street between King and Bryant
What: Utility installation and street restoration work

What: Street and sidewalk restoration
Time: 7 a.m. - 5:30 p.m.
When: Monday to Saturday
Where: 4th Street between King and Welsh

What to expect

  • Work may involve saw-cutting, potholing and jack-hammering on the roadway and sidewalk
  • Sidewalk access may be limited
  • Access will remain open for pedestrians and businesses
  • Parking and Traffic Impact
    • Partial lane closures on 4th Street between Townsend and King streets.
    • Parking will be unavailable in the work area on both sides of 4th Street.
    • Two lanes of traffic open on 4th Street, one on the east side and one on the west.
    • Traffic impacts are in effect 24 hours a day.
  • Muni Impact
    • Bus stops for the 47 bus inbound have been relocated to 4th and Bryant and 4th and Townsend.

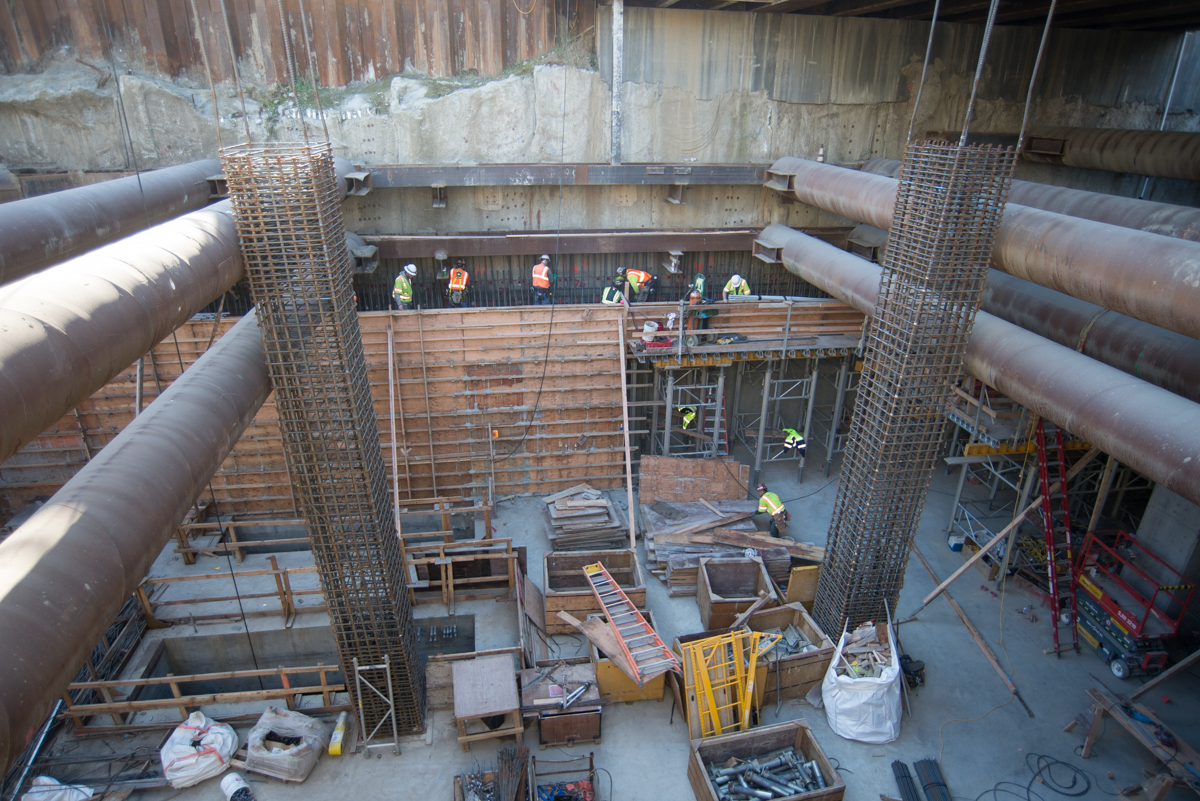

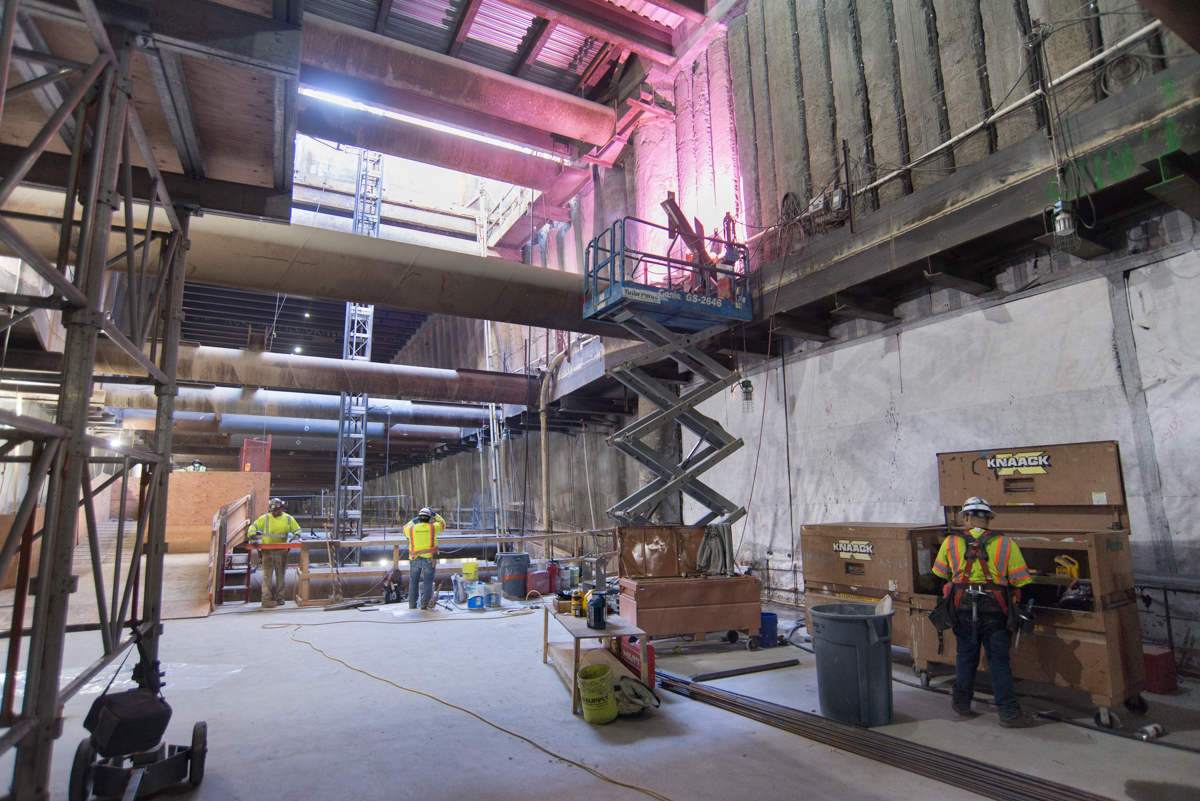

Rebar cages for two massive future columns inside the station headhouse reach toward the surface, while workers continue building internal walls and concrete forms. Yerba Buena | Moscone Station

4th Street from Howard to Folsom

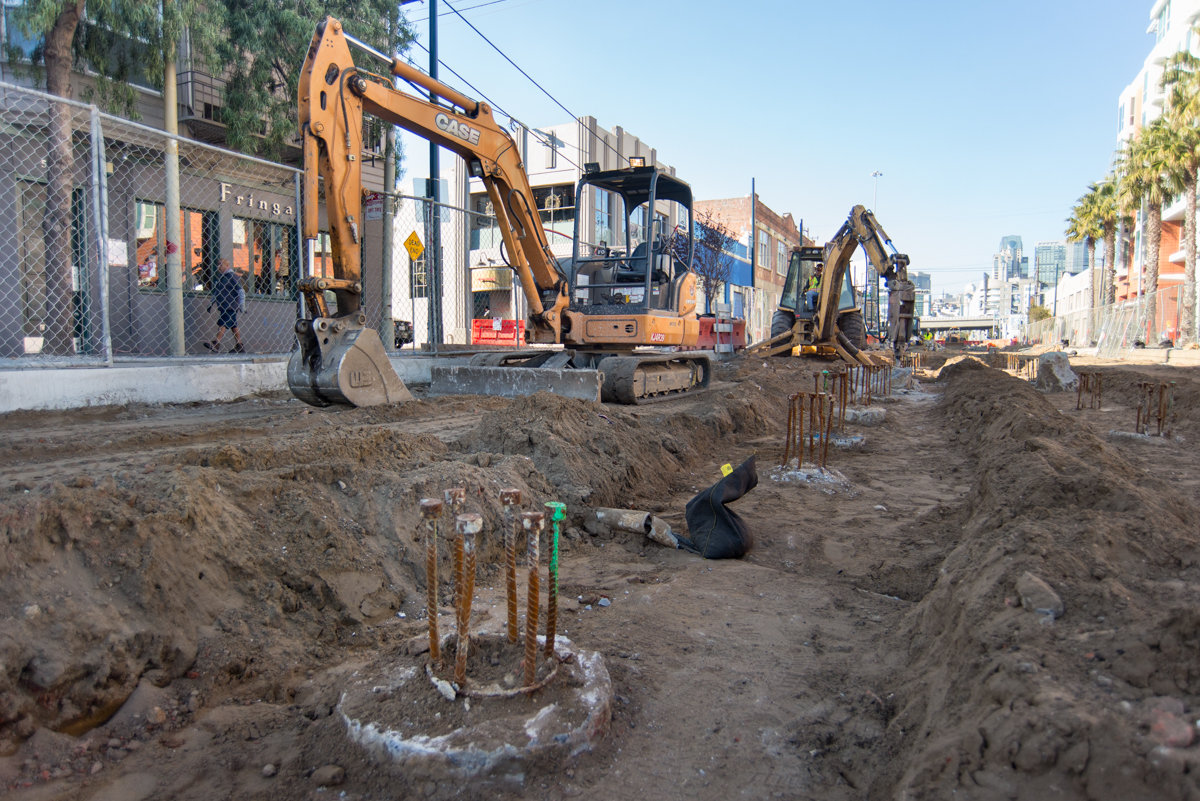

Work along 4th Street between Howard Street and Folsom Street consists of construction of the underground Yerba Buena | Moscone Station. The cut and cover method involves construction of a box frame structure within a trench excavation that is subsequently backfilled.

Sewer replacement work continues at night at 4th and Howard streets until Thanksgiving. Work hours are 8 p.m. to 5 a.m.  The current traffic configuration from north of the station to Howard Street will remain, but may change in the coming weeks. Two through lanes are in place southbound 4th Street. Westbound traffic on Howard Street will be impacted.

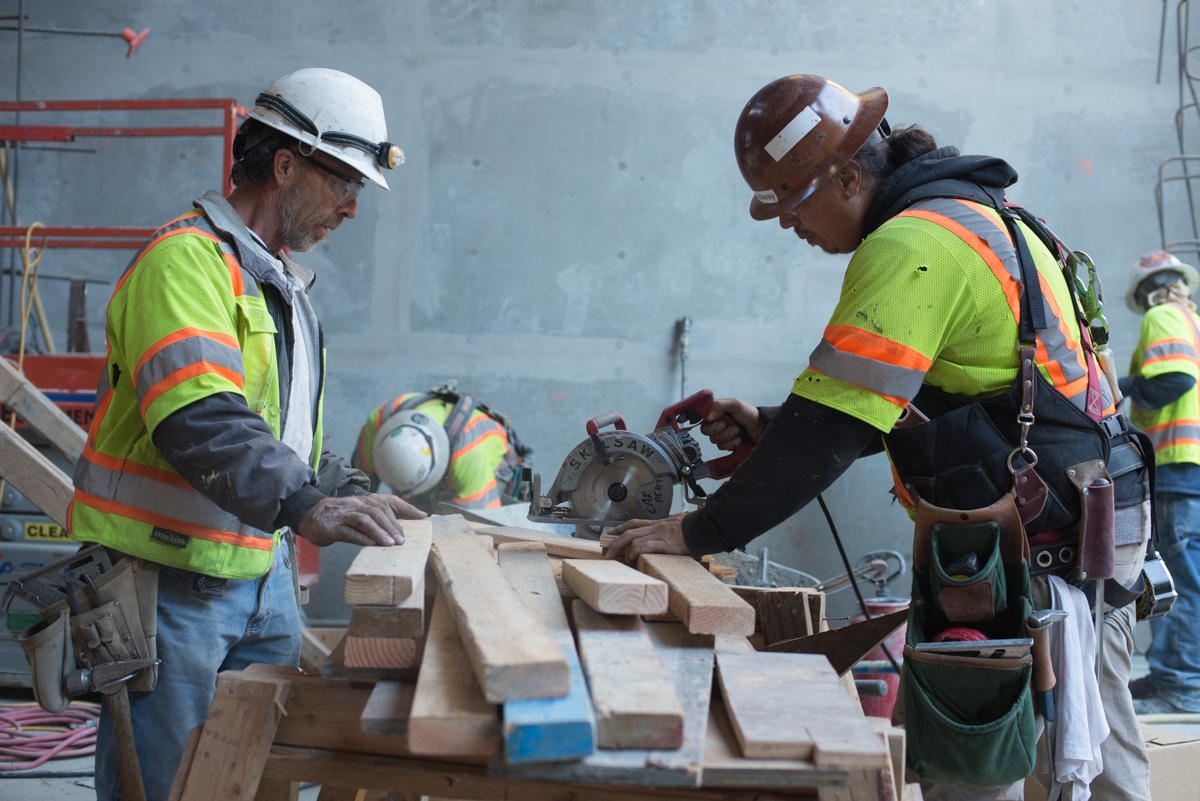

Carpenters cut boards as part of concrete form construction work inside the station headhouse. A crew installs rebar as part of mezzanine floor slab preparation work toward the south end of the station headhouse. Overview

  • Sewer replacement work at 4th and Howard
  • Installation of headhouse and station interior elements
  • Roadway and sidewalk restoration on 4th south of Howard

Details

What: Sewer replacement work
Time: 7am - 3pm
When: Monday to Friday
Where: 4th and Howard Street intersection.

What: Installation of headhouse and station interior elements
Time:  7am - 7pm
When: Monday to Friday
Where: 4th Street between Howard Street and Folsom Street

What: Roadway restoration on the west side of 4th Street south of Howard
Time:  7am - 4pm
When: Monday to Friday
Where: 4th Street between Howard Street and Folsom Street

What: Curb installation work
Time: 7am - 7pm
When: Monday to Saturday
Where: Clementina between 4th and 5th What to expect

  • Clementina Street is closed for traffic and pedestrians through to 4th Street
  • The sidewalk on the west side of 4th Street is closed south of Howard
  • Parking and Traffic Impact
    • Two lanes of traffic open on the east side of 4th Street, may be reduced to one lane at night between 9 pm and 5 am Monday through Friday.
  • Muni Impact
    • No scheduled impacts at this time

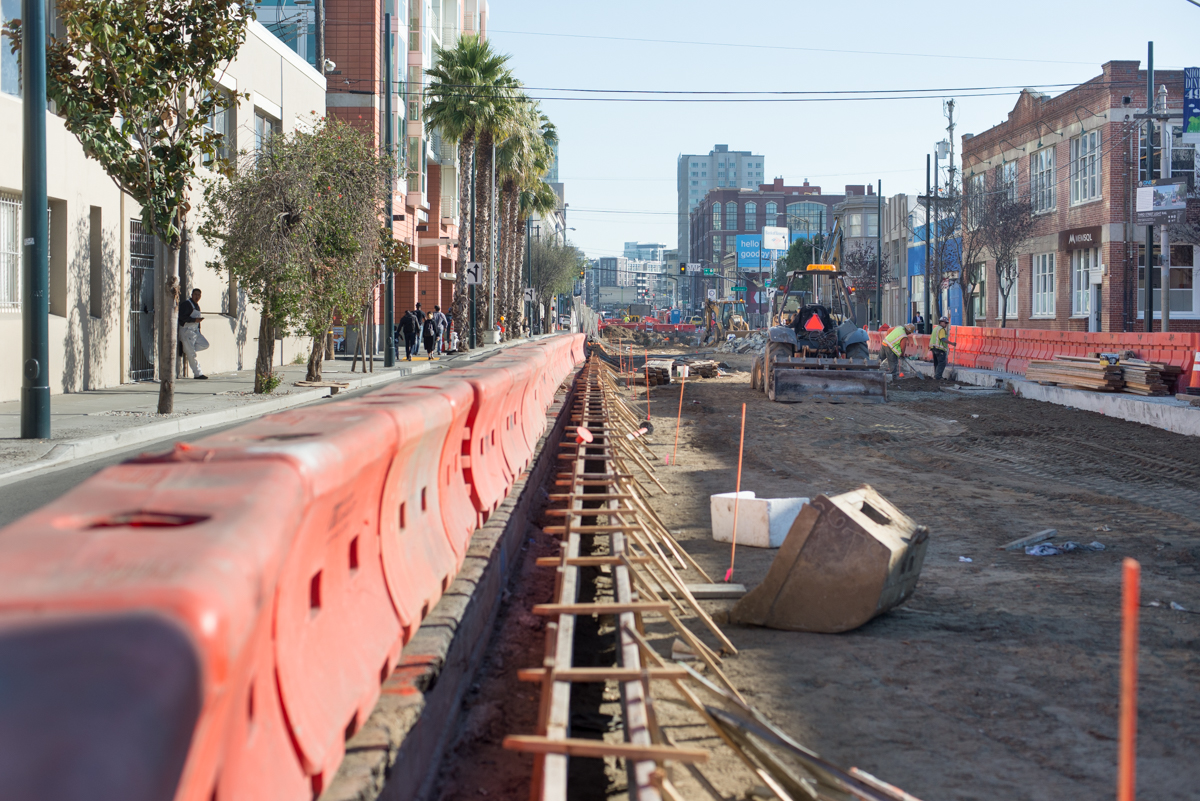

    The 2017 Winter Walk is in full swing along Stockton between Geary and Ellis, with illuminated benches, decorations, vintage inspired lighting, food trucks, and a cocktail garden. Union Square | Market Street Station

    The construction of an underground Union Square|Market Street Station uses the cut and cover method known as a "top-down" or "bottom-up" approach and involves construction of a box frame structure within a trench excavation that is subsequently backfilled. Some work continues at night along Stockton Street between Ellis Street and Post Street.

    One lane on the south side of Ellis Street is open at all times for eastbound traffic.  Parking garage access is open on north side of Ellis Street. Street restoration work is continuing north of the intersection of Stockton and Market streets.  The installation of waterproofing, structural steel, and concrete at the southeast corner of the Union Square Garage continues.  There will be a continued presence of vehicles and equipment as work at this location continues.  Installation of internal structural elements and utilities is ongoing under Stockton Street as well as the northeast corner of Stockton and O'Farrell.

    A welder constructs a hoist inside the north station concourse, under the Geary and Stockton intersection. Holiday shoppers and locals enter the 2017 Winter Walk along the east side of Stockton Street from Market. Overview

    • Utility work at the Ellis and Stockton intersection
    • Utility work at the Geary and Stockton intersection
    • Installation of internal structural elements and temporary bracing
    • Union Square Garage plaza level concrete and structural installation
    • Union Square Garage plaza temporary bracing installation

    Details

    For all activities, construction hours may be 24 hours a day, Monday to Saturday, Sunday work may be required What to expect

    • Sidewalk access may be limited at times
    • Parking and Traffic Impact
      • Stockton Street between Ellis Street and Geary Street is closed to vehicular traffic
    • Muni Impact
      • No scheduled impacts at this time.

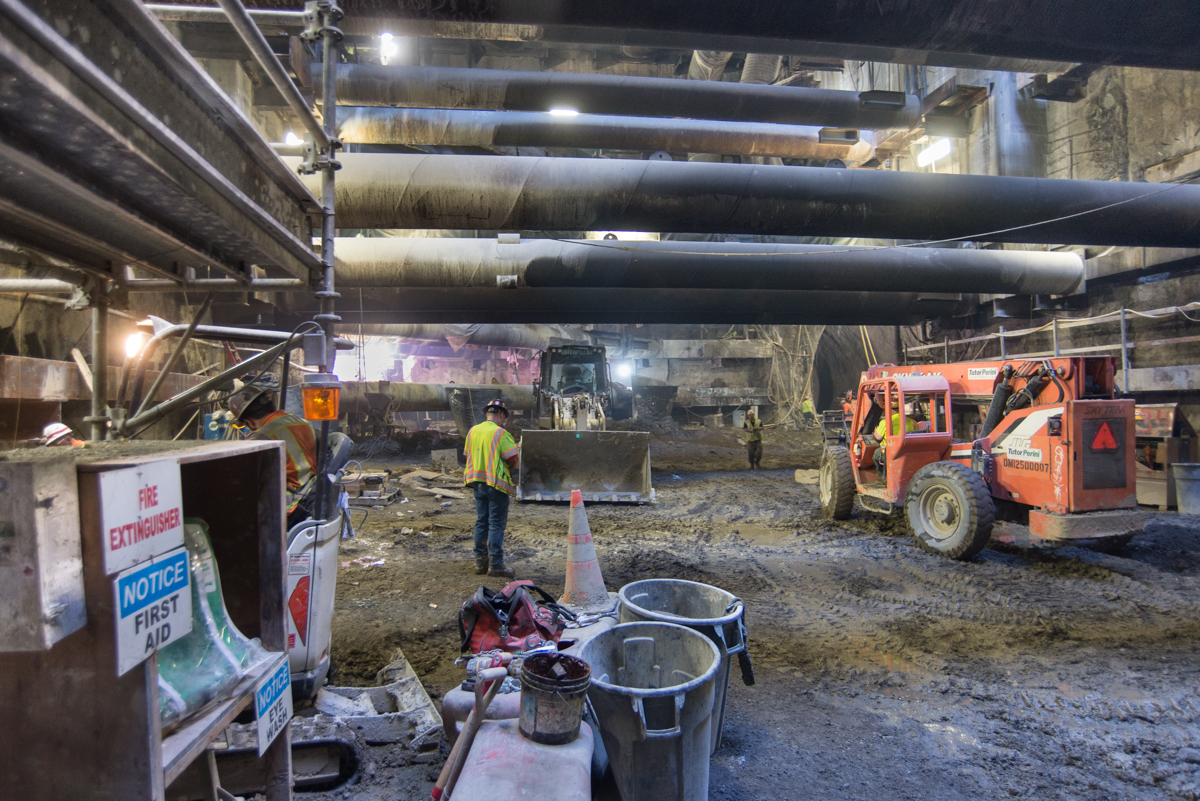

    Workers are shifting operations slightly in preparation of resuming excavation work inside the Chinatown Station headhouse. Chinatown Station The construction of Chinatown Station uses the sequential excavation method (SEM) along Washington Street and Stockton Street. The SEM provides a high degree of flexibility during construction and makes it possible to control virtually all kinds of ground conditions, thereby greatly reducing the risks of construction. This method of tunnel construction is used worldwide for small to large openings in a variety of ground types ranging from rock to soil.

    Sprayed concrete (shotcrete) and other supporting elements are applied and installed promptly after exposing ground, which provides a safe and stable opening.

    Current activities include excavation of the north and south platform caverns.  A pedestrian walkway is open on the north side of Washington connecting Trenton and Stockton.

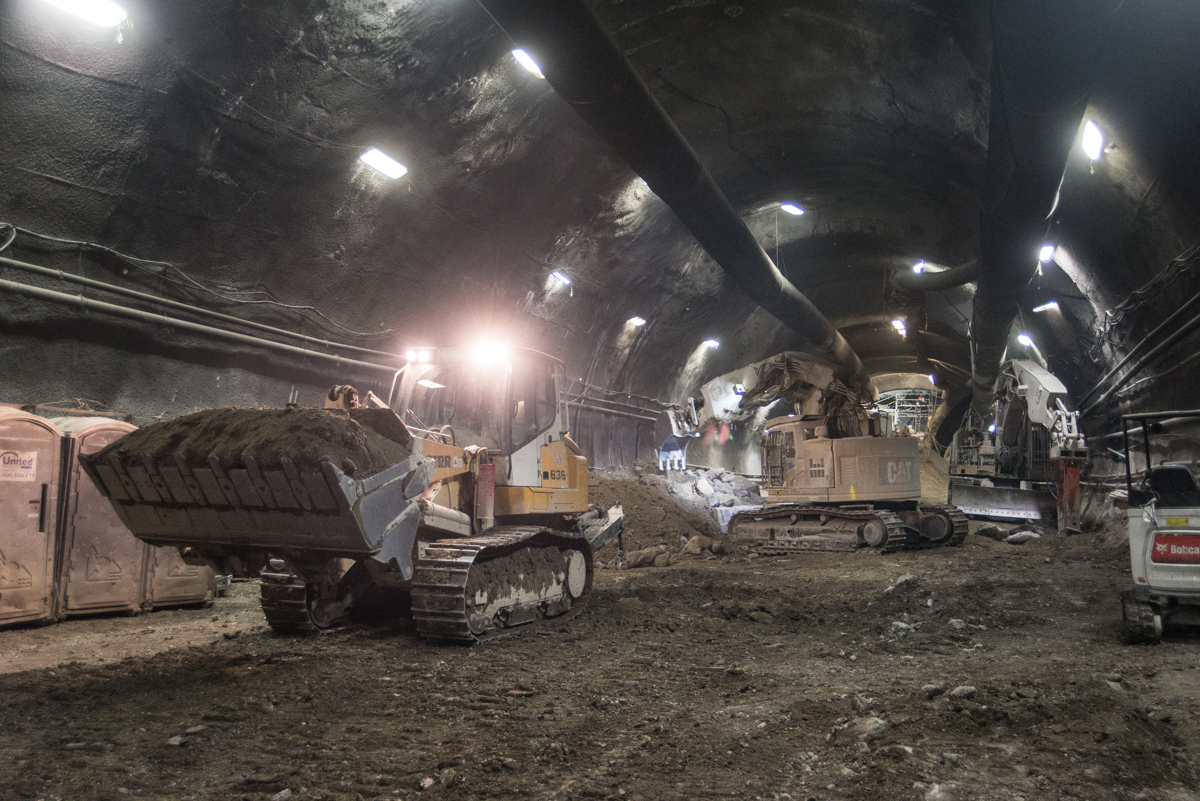

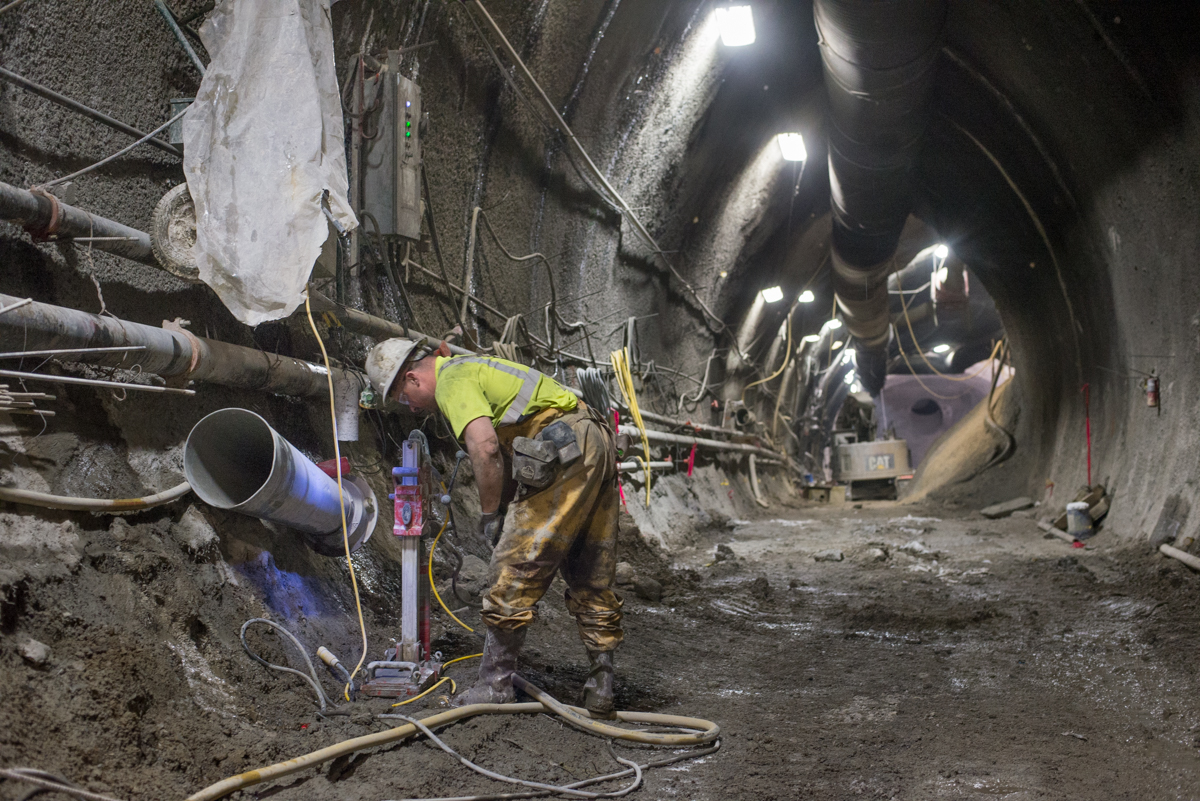

    A bulldozer runs laps carrying buckets of excavated material from a collection area inside the south platform cavern. A worker maintains equipment in the right side drift toward the south end of the Chinatown platform cavern. Overview

    • Excavation of station headhouse
    • Excavation of the north and south platform caverns

    Details

    What: Station site excavation
    Time: 24 hours
    When: Monday to Saturday
    Where: Stockton Street and Washington Street What to expect

    • Sidewalk access may be limited at times
    • Parking and Traffic Impact
      • No parking on both sides of Stockton Street between Washington Street and Jackson Street
      • One lane of traffic on both sides of Stockton Street between Washington Street and Jackson Street
      • Washington Street:
        • remains closed between Stockton Street and Trenton Street, except to pedestrians
        • is converted into a two-way street between Powell Street and the construction zone
    • Muni Impact
      • No scheduled impacts at this time.
